Commercial Solar Charging Integration Explained for Businesses

Commercial solar charging integration is the process of combining solar photovoltaic (PV) systems with electric vehicle charging stations to deliver renewable, cost-saving power across commercial facilities and fleets. For business owners and facility managers, this approach to solar energy integration does more than cut electricity bills. It helps your operation lower energy costs, reduce carbon emissions, and future-proof your site for growing EV fleets. The technical term used across the industry is solar PV and EV charging co-integration, and understanding how it works at a commercial scale is the first step toward making a confident investment.

How does commercial solar charging integration work?

Commercial solar charging integration connects a rooftop or ground-mounted solar PV array to your building’s electrical infrastructure, which then powers Level 2 or DC fast chargers for your fleet or customer vehicles. The solar panels generate direct current (DC) electricity, which an inverter converts to alternating current (AC) for use by your chargers and facility loads. Any surplus power feeds back to the grid or into battery storage for later use.

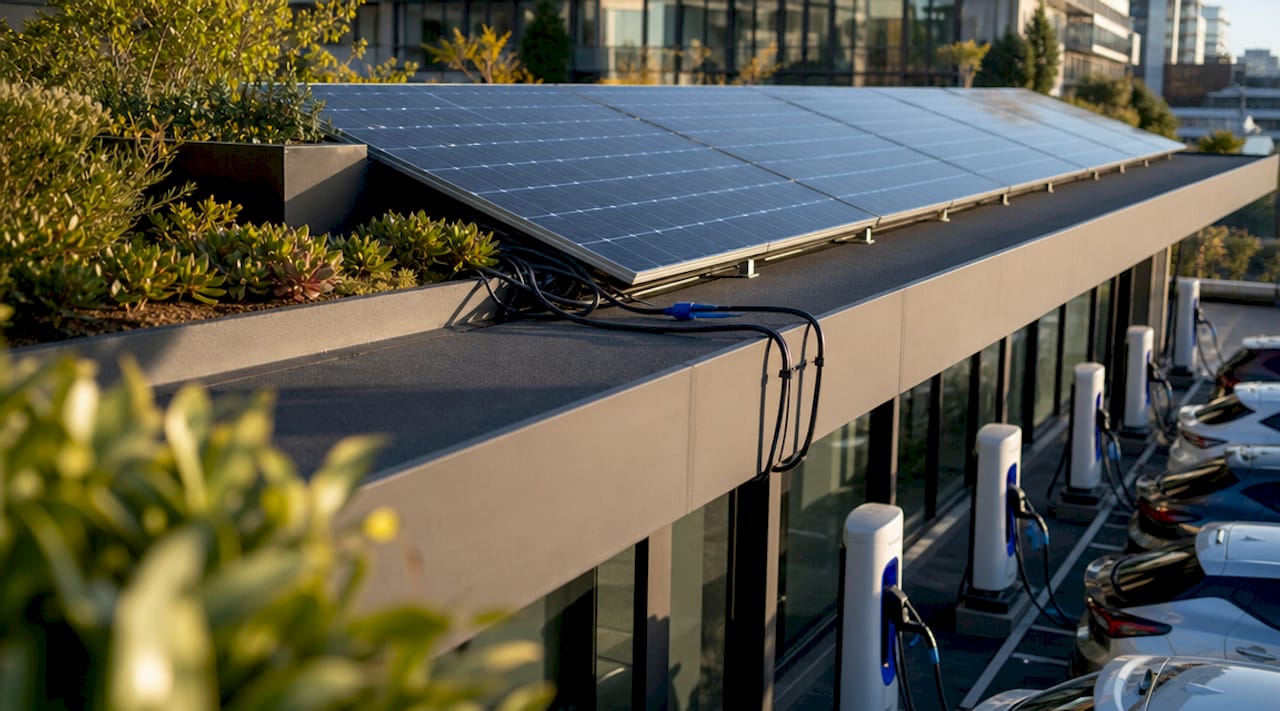

Rooftop solar array paired with EV charging stations

The key difference from a residential setup is scale and electrical complexity. Commercial solar systems operate on three-phase power and must comply with IEEE 1547-2018 standards, including mandatory anti-islanding testing and protection relay settings. Anti-islanding means the system automatically disconnects from the grid during an outage, protecting utility workers from live lines. These requirements are non-negotiable for legal operation.

Here is how the core integration process works, step by step:

  1. Solar array generation. Panels convert sunlight to DC electricity. String sizing accounts for temperature extremes to prevent inverter shutdown.
  2. Inverter conversion. A grid-tie or hybrid inverter converts DC to three-phase AC power matched to your facility’s voltage.
  3. Distribution to EV chargers. Power routes through your main electrical panel to dedicated EV charging circuits, often Level 2 (208/240V) or DC fast chargers.
  4. Utility interconnection. Your system connects to the grid via a supply-side connection per NEC 705.12(B), which avoids the busbar loading limits that apply to residential back-fed breakers. Utilities prefer this method for systems over 100 kW.
  5. Energy management. A smart energy management system (EMS) monitors generation, load demand, and grid pricing to dispatch power where it is most cost-effective.

Pro Tip: Request your utility’s interconnection application checklist before finalizing your system design. Utility timelines for commercial interconnection studies can run 3 to 6 months, and starting early prevents costly project delays.

What are the financial benefits and incentives for 2026?

The financial case for commercial solar charging depends on your utility rates, your demand charges, and the incentives available in your state. Here is what to evaluate before committing to a project timeline.

Factor Details
Depreciation Commercial equipment may qualify for accelerated depreciation; confirm treatment with your tax advisor
State and utility rebates Vary by location; check your utility and state energy office for current programs
Demand charge savings Depend on pairing solar with battery storage or an EMS that shifts power to peak windows

Commercial solar installation costs range from $1.40 to $3.80 per watt in 2026, putting a 200 kW system between $280,000 and $760,000 before incentives. That range is wide because site conditions, roof type, and local labor rates all factor in. Payback depends heavily on your electricity rates, demand charges, and available state and utility incentives, so model it with your own utility bills.

Infographic showing five steps of commercial solar charging integration

One cost factor many facility managers overlook is demand charges. Demand charges account for 30 to 50% of commercial electricity bills, and solar alone rarely reduces them without paired battery storage or an intelligent EMS. This means the financial model for your project must include storage if demand charge savings are part of your ROI calculation.

What are the key technical and operational considerations?

Getting the technical design right separates a high-performing solar charging system from one that underdelivers or fails utility inspection. Several factors deserve close attention before you finalize your design.

String sizing and voltage management. Commercial string sizing must account for voltage fluctuations during temperature extremes. In cold climates, open-circuit voltage can spike and trip inverters or trigger permit rejections. The typical commercial DC-to-AC ratio runs between 1.2 and 1.4 to maximize inverter utilization while preventing clipping losses.

Protection relay commissioning. Protection relay settings must align exactly with your utility’s specifications. This means commissioning tests that verify trip functions at precise voltage and frequency thresholds per IEEE 1547-2018. This step is frequently skipped by less experienced installers, and it is one of the most common reasons commercial solar projects fail final utility approval.

Battery storage and energy management. A smart-grid integrated EMS focused on generation-cost minimization delivers better long-term economics than one optimizing for output alone. Pairing solar with a battery system like a hybrid solar kit lets you store midday generation and dispatch it during peak demand windows, directly cutting demand charges.

Key operational factors to address during design:

  • Load profile analysis. Map your facility’s hourly energy use to identify peak demand windows and size storage accordingly.
  • EV charging load forecasting. Account for fleet growth over 5 to 10 years so your system is not undersized within two years of installation.
  • Monitoring and SCADA integration. Real-time monitoring through a SCADA or cloud-based EMS lets you track performance, catch faults early, and document generation for your records.
  • Maintenance planning. Commercial inverters require periodic firmware updates and annual inspection. Factor this into your operating budget from day one.

Pro Tip: If your facility runs multiple EV chargers simultaneously, use a dynamic load management system to prevent demand spikes. This software coordinates charger output in real time, keeping your peak demand flat and your utility bill predictable.

How to plan and implement a commercial solar charging project

A well-structured implementation process prevents cost overruns and keeps your project on schedule. Here is a practical sequence for moving from concept to operation.

  1. Conduct a site assessment. Evaluate roof or ground space, structural load capacity, shading, and existing electrical infrastructure. Confirm your utility’s interconnection requirements and queue timelines at this stage.
  2. Develop a system design. Work with a licensed electrical engineer to size the solar array, inverter, battery storage, and EV charging circuits together. If you are building new construction, integrating solar in the schematic design phase lowers installation labor by approximately 45% compared to retrofitting an existing building.
  3. Submit interconnection and permit applications. File your utility interconnection application and local building permits simultaneously. Utility studies for commercial systems can take 3 to 6 months. Starting both processes in parallel saves significant time.
  4. Select qualified installers. Choose contractors with documented experience in commercial three-phase solar systems and IEEE 1547-2018 compliance. Ask for references from projects of similar scale and request copies of their protection relay commissioning reports.
  5. Coordinate EV charger procurement. Source your commercial EV chargers alongside your solar equipment so installation timelines align. Mismatched lead times are a common cause of project delays.
  6. Commission and test. Complete protection relay testing, anti-islanding verification, and EV charger load testing before final utility inspection. Document everything for your utility and permitting records.
  7. Monitor and optimize post-installation. Use your EMS data to refine charging schedules, identify underperforming strings, and track demand charge savings against your original financial model.

Why commercial solar integration is more complex than it looks

There is a tendency among business owners to treat commercial solar the same way they think about residential solar. You put panels on the roof, you save money. That framing misses most of what actually determines whether a commercial project succeeds.

Commercial solar is fundamentally a utility interconnection project where protection coordination and compliance drive long-term success far more than the visible hardware does. Commercial projects can stall for months when protection relay commissioning is skipped or the wrong interconnection form is filed. The panels can be perfect while the paperwork is not.

Another common assumption is that solar alone solves your energy cost problem. Facility managers consistently underestimate the role demand charges play in their total bill. Solar generation peaks at noon. Your demand peak may hit at 4 p.m. when your fleet plugs in. Without storage and a smart EMS, you are generating power at the wrong time and still paying peak demand rates. Strong projects combine solar, a battery system, and dynamic EV load management from the start.

The good news is that when you get all three working together, the economics are genuinely compelling. A system designed this way, lasting 25 years, makes a strong business case.

Find the right commercial EV chargers for your solar project

Ready to move from planning to purchasing? Chargeprodirect makes it straightforward to find commercial EV charging equipment that works with your solar integration design.

https://chargeprodirect.com

Use the commercial EV charger finder to match networked chargers to your facility’s power setup, fleet size, and solar system specs. Detailed product specs help you check amperage and inverter compatibility before installation. You can also browse solar inverters designed for grid-tie and hybrid applications, or explore complete hybrid solar kits that bundle panels, storage, and inverter technology in one package. Flexible payment plans are available at checkout.

Key takeaways

Commercial solar charging integration delivers its strongest returns when solar, battery storage, and smart energy management are designed together from the start.

Point Details
Demand charges require storage Solar alone rarely reduces demand charges; pair it with battery storage and an EMS for full savings.
IEEE 1547-2018 compliance is mandatory Protection relay commissioning and anti-islanding testing are required for legal utility interconnection.
New construction saves 45% on labor Integrating solar during schematic design cuts installation costs significantly versus retrofitting.
Payback depends on your site Model payback with your own utility bills, demand charges, and state or utility incentives.

FAQ

What is commercial solar charging integration?

Commercial solar charging integration is the combination of a solar PV system with EV charging infrastructure to power electric vehicles using renewable energy at a commercial facility. The industry standard term is solar PV and EV charging co-integration, and it requires three-phase electrical design, utility interconnection compliance, and often battery storage to perform effectively.

How much does a commercial solar charging system cost in 2026?

Commercial solar installation costs range from $1.40 to $3.80 per watt in 2026, before incentives. Payback depends on your utility rates, demand charges, and available state and utility incentives.

Do I need battery storage with commercial solar for EV charging?

Battery storage is not required, but it is strongly recommended. Demand charges account for 30 to 50% of commercial electricity costs, and solar generation alone does not reduce them without storage or an intelligent energy management system to shift power to peak demand windows.

What compliance standards apply to commercial solar installations?

Commercial solar systems must comply with IEEE 1547-2018, which requires anti-islanding protection, protection relay commissioning, and utility-approved trip settings for voltage and frequency. Supply-side connection per NEC 705.12(B) is the preferred method for systems over 100 kW.
